The Owner’s Guide: Construction Change Order Management

August 5, 2026

Project overages doesn’t manifest at bid day. They quietly bleed capital when you receive a two-page form with a compelling reason, a large number at the bottom, and a blank signature line. Effective construction change order management is how owners protect project capital before those adjustments turn into sunk costs.

An important truth up front: exceptional contractors welcome this level of owner discipline. Reputable builders operate on transparency, clear documentation, and prompt execution. A structured review process doesn’t penalize good contractors—it protects both parties from scope creep, ambiguous directives, and delayed payments. It simply ensures that every dollar spent is legitimate, fully backed by field data, and contractually earned.

Industry benchmarks show commercial change orders consume an average of 10% to 14% of total contract value. On a $5M project, that represents $500,000 in scope adjustments. Most are evaluated by an owner with limited construction pricing experience against a team that prices work every week.

What a Construction Change Order Actually Is

A construction change order is a legally binding amendment to your original contract that formally adjusts scope, price, or schedule. Until authorized parties sign that document, no additional work should proceed, and you owe zero extra dollars.

Verbal approvals, job-site nods, and informal emails are not change orders—they are legal disputes waiting to happen. The structural problem on most job sites is information asymmetry: the contractor writes the proposal, prices the work, and defines the schedule delay. The owner simply signs. A disciplined review process balances that table.

The Four Triggers Behind Scope Adjustments

Understanding why a change order exists dictates how aggressively you inspect the pricing:

  • 01. Incomplete or Ambiguous Documents: Drawings that conflict with specifications force field teams to stop, issue a Request for Information (RFI), and submit a cost impact. Thorough constructability reviews during design eliminate the vast majority of these gaps before ground break.
  • 02. Unforeseen Site Conditions: Hidden utilities, poor subsurface soil, or concealed structural issues during renovation. These are legitimate, but they still demand full field documentation and line-item pricing audits.
  • 03. Owner-Initiated Scope Changes: Upgraded finishes or expanded program footprints. Requesting a change does not mean accepting unfair pricing; owner-driven adjustments require the exact same review rigor.
  • 04. Contractor-Initiated Claims: Productivity impact claims, re-sequencing fees, or extended overhead requests. Scrutinize this category hardest and require detailed line-item backup for every single dollar.

The Change Order Management Workflow

Never begin a change order review with a final number. Demand a disciplined four-step paper trail before committing capital:

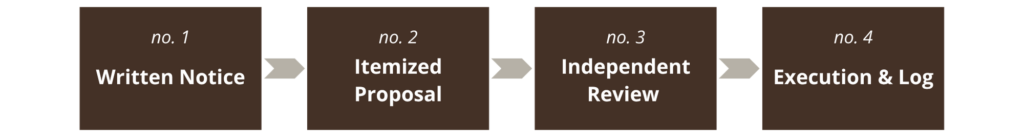

No. 1 – Written Notice (Before Work Begins)

The moment a team identifies a potential change, they must issue written notice and capture field evidence—using field reports, photos, or 3D reality capture and site documentation—before starting the work.

No. 2 – Itemized Cost Proposals

A lump sum with no backup is not a proposal—it’s an unverified invoice. Require an itemized breakdown separating labor hours, unit material costs, equipment daily rates, subcontractor totals, and contract-defined markup fees.

No. 3 – Independent Line-Item Audit

Review the proposal independently before starting negotiations. Verify that material quantities match field realities and that labor estimates reflect actual work requirements rather than inflated averages.

No. 4 – Real-Time Log Tracking

Once negotiated, execute the signed change order, update contract documents, and track the work under its own isolated cost code. Maintain an active Change Order Log—your project’s financial scoreboard—and review it at every owner-contractor meeting.

Unsure if your project contracts protect you from change order creep? Run your project through our free, self-guided 3P Assessment to identify hidden vulnerabilities before signing your next agreement.

Calculating Real Cost and Schedule Impact

To evaluate whether a proposal holds up under scrutiny, apply these three engineering standards:

The Cost Build-Up Formula

Defensible change order pricing follows a strict sequence: direct costs first (labor, materials, equipment), then indirect site overhead, followed by the contract-allowable markup.

Standard commercial agreements (like AIA or ConsensusDocs) typically cap combined overhead and profit at 15%. If a contractor submits markups above your contractual cap, treat it as an unallowable cost.

The Critical Path Test for Time Extensions

A change order adds calendar days to your project only if the work directly delays the critical path. If the added work sits on an activity with available schedule float, the schedule impact is zero—regardless of the dollar cost. Require a CPM (Critical Path Method) time-impact analysis aligned with industry standards for time impact claims for every schedule extension request.

Extended General Conditions

Contractors must calculate supervision fees, site trailer power, and temporary utilities using a verified daily rate multiplied by documented critical-path delay days—never round-number estimates.

Change Order Red Flags: What to Audit and Reject

When conducting a change order review, flag and audit these common risk areas immediately:

Red FlagThe Hidden RiskThe Required Fix
Vague Scope Lines“Additional work per field directive” masks unverified labor.Demand drawing references, RFI numbers, and exact site measurements.
Double-Counted OverheadContractors bake overhead fees inside direct material lines, then charge them again as a top-line percentage.Strip hidden markups out of individual line items.
Pass-Through Lump SumsSubcontractor quotes submitted with zero line-item breakdown.Require full itemized labor/material backup from the trade sub.
Retroactive SubmissionsContractors submit change orders weeks or months after field execution.Enforce strict contract clauses requiring prior written notice.
Unsupported Time ClaimsA 15-day delay attached to a minor $4,000 electrical adjustment.Reject time extensions that lack a CPM schedule analysis.

Independent Technical Oversight

A complete, audit-ready change order packet contains the signed authorization form, itemized contractor proposals, independent review notes, supporting RFI/drawings, schedule impact analyses, and an updated master log. If you cannot reconstruct why a change occurred three years later, your documentation failed.

Platforms like Procore, Autodesk, or Buildertrend assist with workflow tracking, while specialized estimating and takeoff software platforms help contractors price scope modifications. However, software cannot evaluate whether a line-item cost is contractually fair to the owner.

When project scope or complexity creates financial risk, bringing in an independent Owner’s Representative balances the equation. At LittleCreek+Co, we apply structural discipline to every change order submission, cross-checking scope, unit pricing, and schedule claims against real-world engineering standards before you commit a single dollar.

Establish Your Baseline

Systematic construction change order management starts long before the first shovel hits the dirt. It relies on protective contract terms, clear written-notice requirements, and an independent review standard that every submission must satisfy.

Before signing your next consultant or contractor agreement, evaluate your project’s underlying risk profile. LittleCreek+Co offers the 3P Assessment—a free diagnostic tool designed specifically for owners navigating residential builds or commercial build-outs. In just seven minutes, this tool evaluates the three pillars of project stability:

  • Priorities: Tests whether your scope, budget, and contingency reserves align with market realities.
  • People: Audits contract terms, change-order protocols, and decision-making authority across your team.
  • Place: Identifies site, zoning, and utility hurdles before capital deployment.

Planning a commercial build-out or residential build? Take the free 3P Assessment now to secure your project foundation before signing your next contract.

Comments

Leave a Reply

Your email address will not be published. Required fields are marked *

headquarters in East texas + nationwide reach

hq in East texas
nationwide reach

privacy policy

+. copyright littlecreek+co 2026. all rights reserved.
